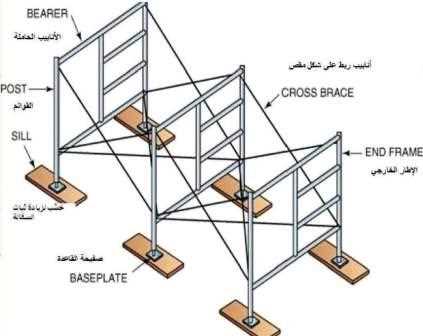

Begin by isolating each structural element of the framework in your reference materials. Use a numbering system or color-coding to match brackets, clamps, and vertical supports to their positions in the assembly instructions. Manufacturers often include tolerances–check for ±2mm deviations in tube diameters, as even minor mismatches can compromise load distribution. For instance, Class 4 components (rated for heavy-duty use) must never be mixed with Class 3 parts, despite superficial similarities.
Inspect cross-bracing connectors first–their angle determines stability under lateral forces. Standard layouts use 45° or 60° configurations, but specialized projects (e.g., bridge falsework) may require custom-jigged diagonal braces. Measure the pin holes in base jacks: a 22mm diameter is standard, but older models may use 19mm, necessitating adapters. Always verify the thread pitch of adjustable heads–metric M36×4.0 is prevalent, but some North American systems use UNC 1.5 threads.
Document load-bearing couplings separately. Swivel couplers (used for non-perpendicular joints) have a limit of 6.3 kN, while right-angle couplers handle 10 kN. Exceeding these values voids safety certifications. For modular systems, create a checklist of every lateral tie and scaffold anchor–each must engage the primary structure at 4-meter intervals horizontally and every 2 meters vertically. Omit no detail: even temporary guardrails require double-locking mechanisms if exceeding 2 meters in height.
Store reference charts in the field kit, including torque specifications. Ledger tubes demand 60 Nm, transoms 50 Nm, and couplers 40 Nm–apply these sequentially to avoid uneven stress. For systems exposed to wind, attach wind girders at internal bays every 6 meters, never at the edges where uplift forces concentrate. Keep a digital catalog of component SKUs: cross-referencing these with the visual breakdown prevents misidentification of visually similar but non-interchangeable parts.
Visual Assembly Guide for Temporary Structures

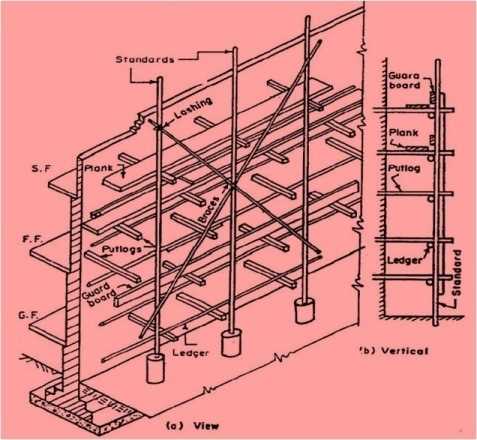

Begin by identifying the base plates–flat, load-distributing components that anchor vertical supports to the ground. Use galvanized steel plates with drainage holes to prevent water accumulation, which accelerates corrosion in high-moisture environments. Position them at least 30 cm apart to maintain lateral stability, adjusting spacing based on the expected load: 1.5 m for light-duty access and 1 m for heavy-duty applications.
Vertical standards–upright tubes–require precise alignment. Secure them to base plates with captive clips or bolts, ensuring no more than 3 mm of play between connections. For uneven terrain, use adjustable screw jacks with a range of 30-50 cm to compensate for height differences. Mark the first standard with spray paint to guide subsequent alignment, reducing cumulative errors by 40% during assembly.
Connecting Horizontal and Diagonal Elements
Attach ledgers (horizontal braces) at 2 m intervals for standard access platforms. Use right-angle couplers, not swivel joints, for primary load-bearing connections–swivels introduce instability under dynamic loads like wind gusts. For diagonal bracing, angle tubes at 45° relative to the vertical plane, fixing them with double couplers at both ends to resist torsion. In seismic zones, add cross braces every 4 m to dissipate lateral forces.
Inspect transom tubes–secondary horizontals–before installation. Reject any with dents exceeding 10% of their diameter or wall thickness variations beyond ±0.5 mm. Space transoms at 1.2 m for scaffolding planks made of laminated veneer lumber and 0.9 m for aluminum decking. Apply anti-slip adhesive strips every 30 cm along transoms to reduce fall hazards, particularly in wet conditions where friction decreases by 60%.

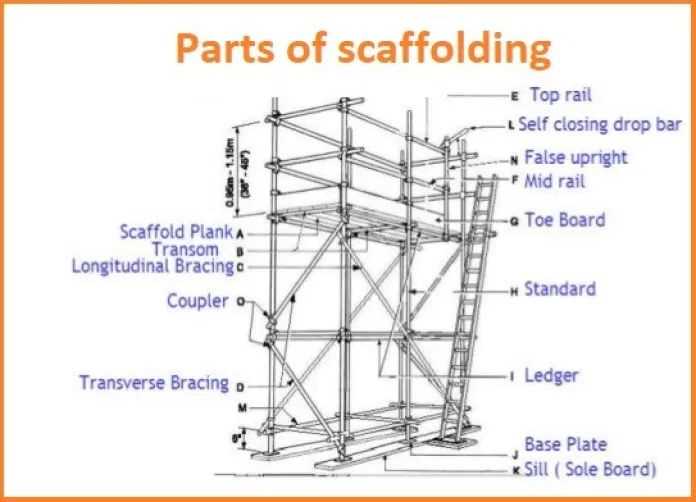

Critical Elements of a Temporary Elevated Framework

Begin assembly with base plates or sole boards to distribute loads evenly–never place vertical supports directly on uneven ground. For standard steel configurations, each base must support at least 20 kN (4,500 lbs) per leg, with adjustable jacks allowing up to 300 mm height modification for leveling on slopes. Verify substrate stability: compacted soil requires 15 mm thick steel plates, while concrete tolerates 10 mm plates. Always secure plates with ground anchors (minimum 450 mm penetration) when wind speeds exceed 38 km/h (24 mph).
- Vertical standards: Use 48.3 mm outer diameter tubes with 3.2 mm wall thickness (EN 12811) for spans up to 2.5 m. Spacing wider than 2.1 m requires double-ledger reinforcement or intermediate transoms. Avoid mixed materials: galvanized steel standards paired with aluminum ledgers reduce load capacity by 18% due to electrochemical corrosion.
- Horizontal ledgers: Install at 2 m vertical intervals for standard access frames, dropping to 1.5 m for heavy-duty applications like masonry. Ledgers must overlap vertical joints by 300 mm and use right-angle couplers (not swivel) for angular connections–these withstand 20 kN shear force vs. 6 kN for swivel types.
- Diagonal braces: Add X-bracing every 5 m horizontally and vertically. Use minimal 40×40 mm lacing bars for tubular structures–thinner braces fail under lateral loads exceeding 0.5 kN/m². For suspended platforms, include two independent tie points per 4 m² of deck area.
Decking materials dictate safety margins: timber boards (minimum 38 mm thick) support 2.0 kN/m², while steel planks (2.5 mm gauge) handle 3.0 kN/m². Gaps between boards must not exceed 25 mm–use toe boards (150 mm high) and handrails (1,100 mm minimum height) on all open sides. For platforms above 2 m, add mid-rails at 500 mm intervals to prevent falls of tools weighing 10 kg+.
Ties to permanent structures demand precise anchoring: through ties (M16 bolts) resist 6.0 kN uplift force, while box ties (for hollow walls) require 80×80 mm plates with two M12 anchors. Space ties at maximum 4 m horizontally and 4.5 m vertically–exceeding these limits increases sway by 40% under wind loads. For freestanding frames above 5 m, add outrigger beams (1.2 m extension) with counterweights (minimum 1.5x platform load).
- Pre-assembly checklist: Verify all couplers torque to 40-60 Nm–over-tightening cracks split sleeves; under-tightening reduces joint strength by 60%.
- Post-erection inspection: Test platform deflection (≤ L/180 span) with a 2.0 kN point load–excessive bounce indicates insufficient diagonal bracing.
- Load rating documentation: Tag each frame with SWL (Safe Working Load), manufacturer, and last inspection date–non-compliant tags void structural warranties.

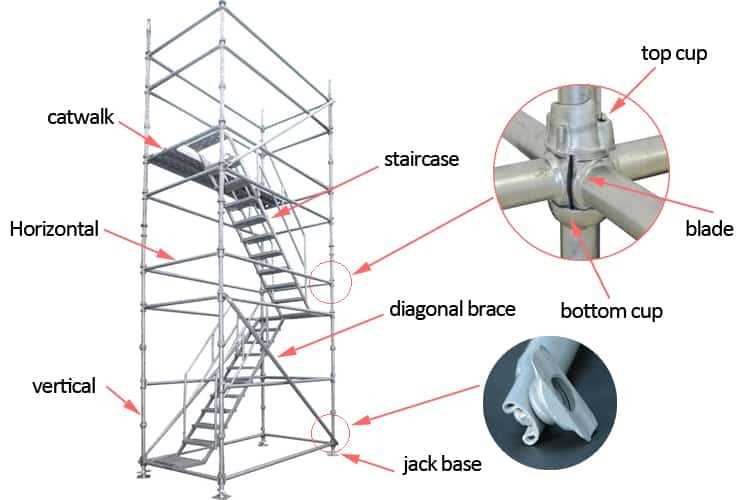

How to Identify and Mark Construction Framework Components

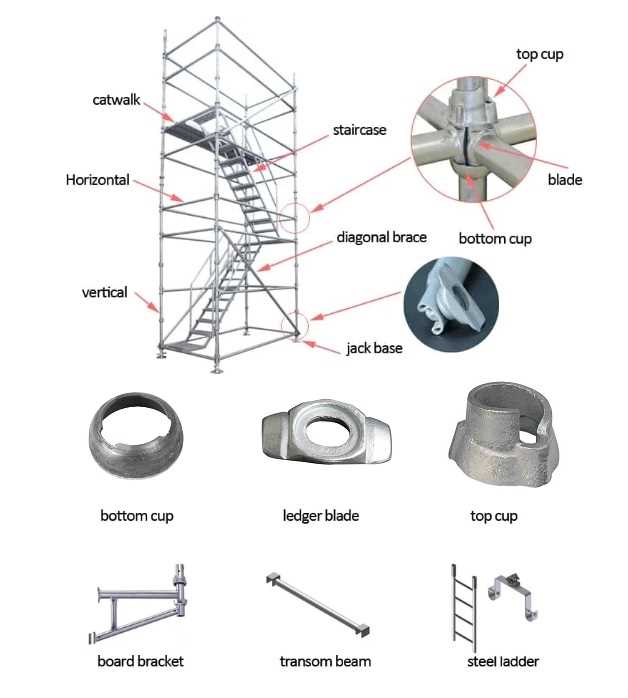

Begin by examining the tube’s color-coding. Industrial standards assign specific hues: galvanized steel (silver-gray), black steel (dark matte), and aluminum (lightweight, often unpainted). Check for stamped markings near the ends–manufacturers imprint batch numbers, grade (e.g., S235, S355), and diameter (typically 48.3mm for standard rigging). If absent, measure wall thickness with calipers: 3.2mm for light-duty, 4.0mm for heavy loads.
Decoding Connection Hardware
Couplers and joints follow a hierarchical system. Right-angle clamps (swivel or fixed) secure perpendicular tubes–look for the manufacturer’s logo (e.g., “BHP” or “Layher”) cast into the body. Sleeve joints, used for axial connections, feature a telltale sleeve length (200–300mm) and locking pin holes. For rosettes or ladder-type rigs, count the evenly spaced holes: 50mm pitch indicates modular grids, 48mm signals heavy-duty scaffolding.
Stenciling should follow a strict protocol. Use weather-resistant paint in 25mm high letters: tube length (e.g., “6.0M”), weight (kg), and inspection date (MM/YY) on opposing sides. For fittings, mark load capacity (e.g., “10kN”) on the clamping face. Avoid permanent markers–UV exposure degrades them in 3–6 months. Store labeled components vertically in racks sorted by size and type to streamline assembly.
Step-by-Step Guide to Interpreting Temporary Structure Assembly Schematics

Locate the legend first. Blueprints for erecting modular frameworks include a key in the bottom corner–often a small table or box–labeling each symbol, line style, and shading. Cross-reference this with the main layout before proceeding: solid lines typically denote rigid tubes, dashed lines indicate braces or adjustable components, and numbered circles mark connection points. Misreading a single symbol can result in reversed components or unsafe spacing.
Trace Component Hierarchy
Begin with the foundational base plates, then follow vertical standards upward. Joints–usually depicted as small crosses or filled circles–must align precisely with predetermined measurements on the schematic; deviations of even 5mm can compromise stability. Group identical sections: horizontal ledgers, diagonal braces, and platform levels often repeat, so note repetition patterns to avoid redundant checks. If the plan uses color-coding, ensure match colors from the legend to physical elements–yellow may signify safety tie-ins, while red highlights load-bearing nodes.
Measure once before assembly begins–use digital calipers for pin-hole diameters indicated in millimeters on the blueprint. Confirm each pin length against tolerance ranges printed alongside symbols. If a component appears ambiguous, compare its position relative to adjacent parts: adjacent ledgers should mirror each other’s spacing mirror within a 2mm variance. Document each verified connection in sequence; a checklist prevents oversight of hidden safety clips or lock mechanisms.
